Construction Update
JUNE 2025

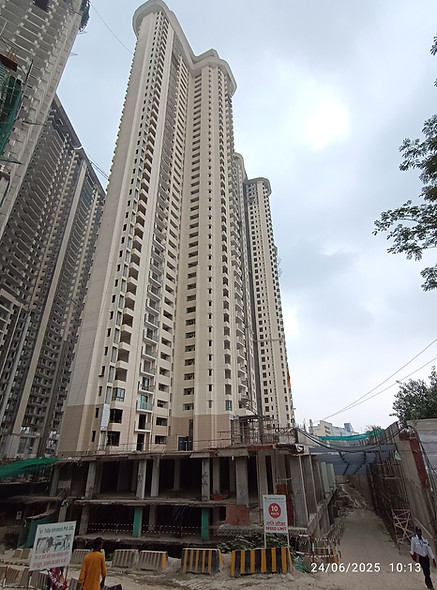

Tower 1
Structure work at 39th floor in progress.
Plumbing Internal: 55% complete
Plumbing External: 50% complete
Fire Fighting: 20% complete
Tile work: 40% complete
Marble Flooring: 15% complete
Door Frames: 30% complete
PoP work: 30% complete
HVAC work: 30% complete

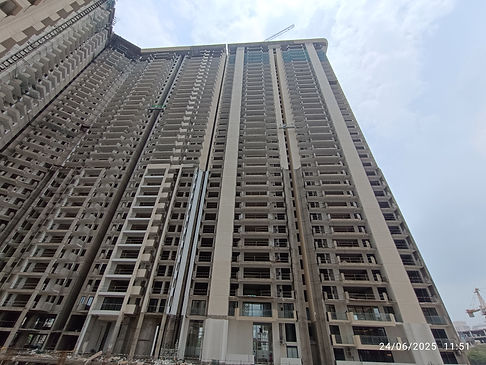

Tower 2
Structure work Complete.
Plumbing Internal: 75% complete
Plumbing External: 50% complete
Fire Fighting: 40% complete
Tile work: 20% complete
Marble Flooring: 35% complete
Door Frames: 60% complete
PoP work: 50% complete
HVAC work: 35% complete

Tower 3
Structure work Complete.
Plumbing Internal: Complete
Plumbing External: 70% complete
Fire Fighting: 90% complete
Tile work: 70% complete
Marble Flooring: 90% complete
Door Frames: 90% complete
PoP work: 90% complete
HVAC work: 90% complete

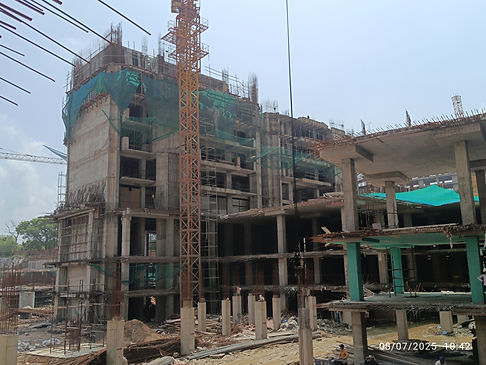

Tower 4
Structure work at 5th floor in progress.
Tower 5
Structure work at 36th floor in progress.


Tower 6
Structure work Complete.
Plumbing Internal: 20% complete
Plumbing External: Started
Fire Fighting: 20% complete
Tile work: 10% complete
Marble Flooring: 20% complete
Door Frames: Started
PoP work: 40% complete
HVAC work: 15% complete

Tower 7
Structure work Complete.
Plumbing Internal: 30% complete
Plumbing External: 10% complete
Fire Fighting: Started
Tile work: Started
Marble Flooring: 10% complete
Door Frames: Started
PoP work: 40% complete
HVAC work: 10% complete



Tower 8
Structure work at 3rd floor in progress.
Tower 9
Structure work at 1st floor in progress.
Tower 10
Structure work at Basement-1 in progress.
